Momscode - Al Manarah - Project Budget

Project

Project Budget

This Module acts sets the Maximum Amount allowed to be spent on Manpower, Materials, and Equipment. It helps to see if the project is making a Profit by comparing the total Budget against the expected revenue

Prerequisites,

  • Project Code
  • Designation
  • Designation Unit Cost
  • Equipment or Vehicle Type
  • Preliminary Cost Categories
  • Item (Raw Materials)

Custom Setting:

  • Standard Working Hours (Per Month)

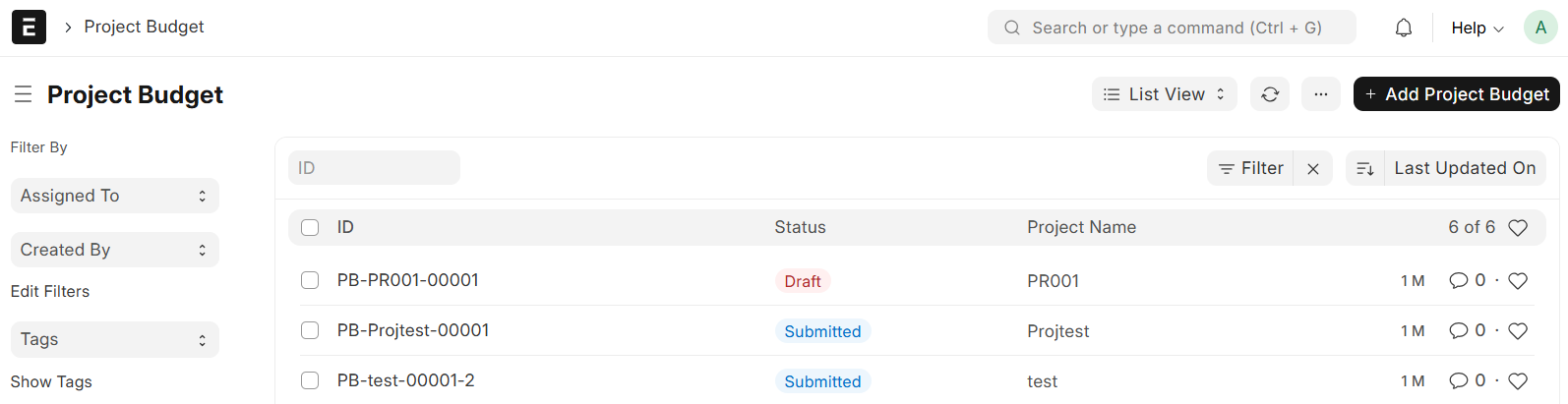

Go to Project Budget List and Click on "Add Project Budget"

{E8828528 281C 44BE B119 A2F9B0494C56}

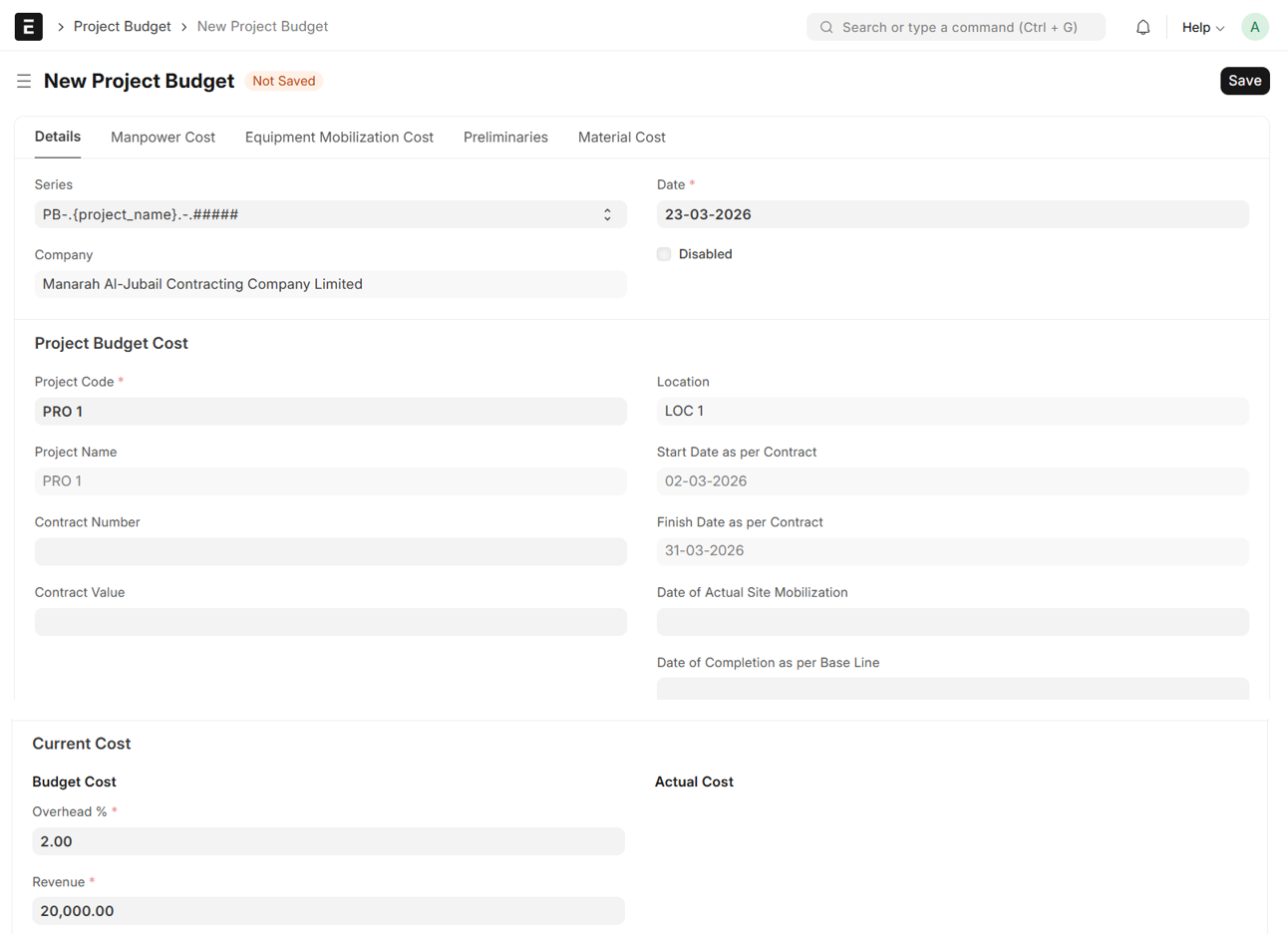

  • Set Date
  • Select Project Code
  • Project Location, Project Name, Start Date as per Contract and Finish Date as per Contract will be auto fetched
  • Enter Overhead %
  • Enter Revenue
  • Save

{88A16B66 6BDB 4050 8645 E5796826826B}

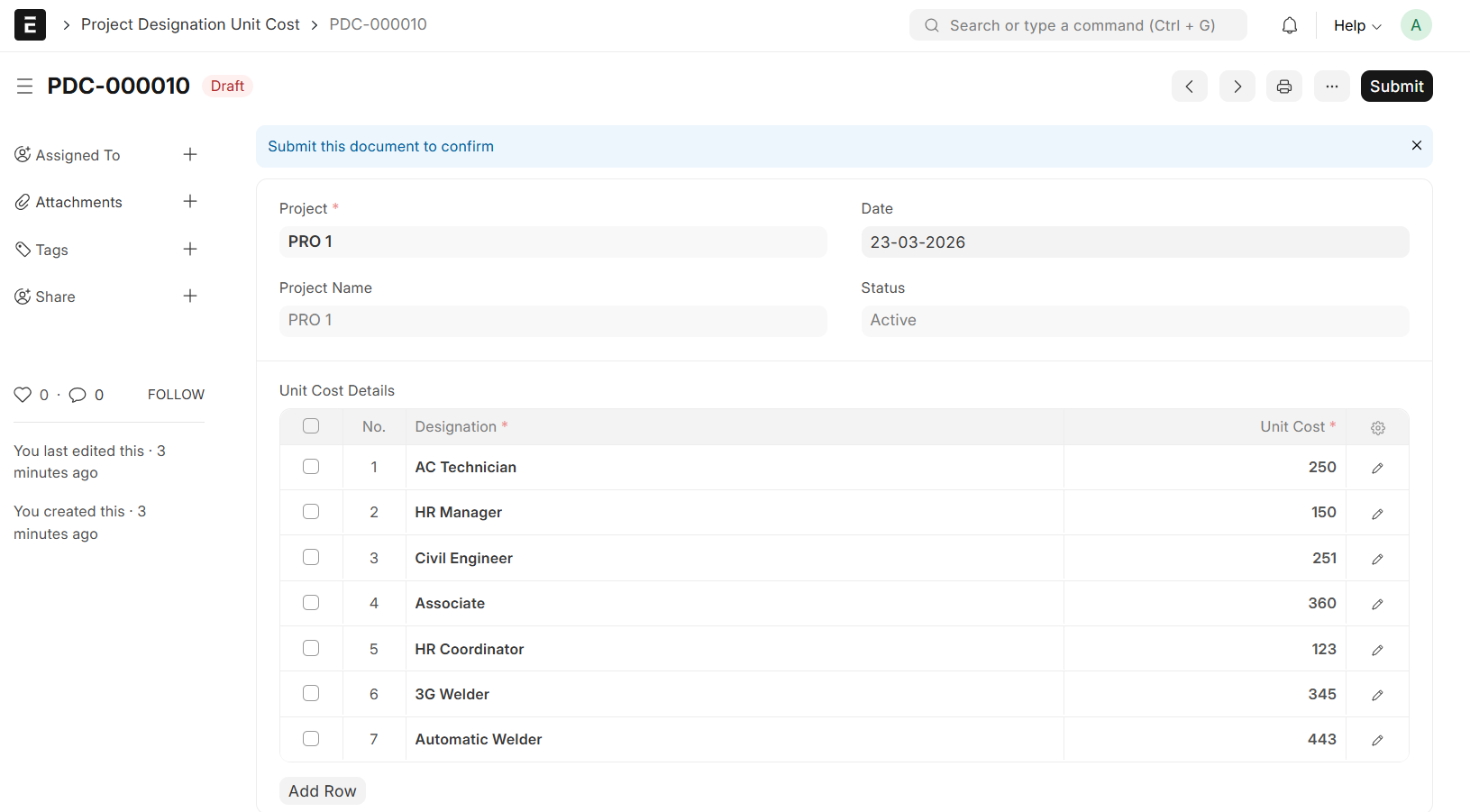

  • Upon Saving, a Project Designation Unit Cost Document will be generated automatically
  • Go to Project Designation Unit Cost and Update the Unit Costs if required, Then Submit the Project Designation Unit Cost

{FA02E6E7 5270 4452 9721 3103BFD474C3}

Manpower Cost

The Manpower Cost section is used to calculate and track the total expense of the people working on your project, ensuring every hour of work is accounted for in the budget

  • In the Manpower Cost section, Add the Designation. The Unit Cost will be automatically fetched from the Project Designation Unit. Click Save to proceed
  • Click on "Create Indirect Manpower Budgeting"
  • Manpower Budgeting will be generated

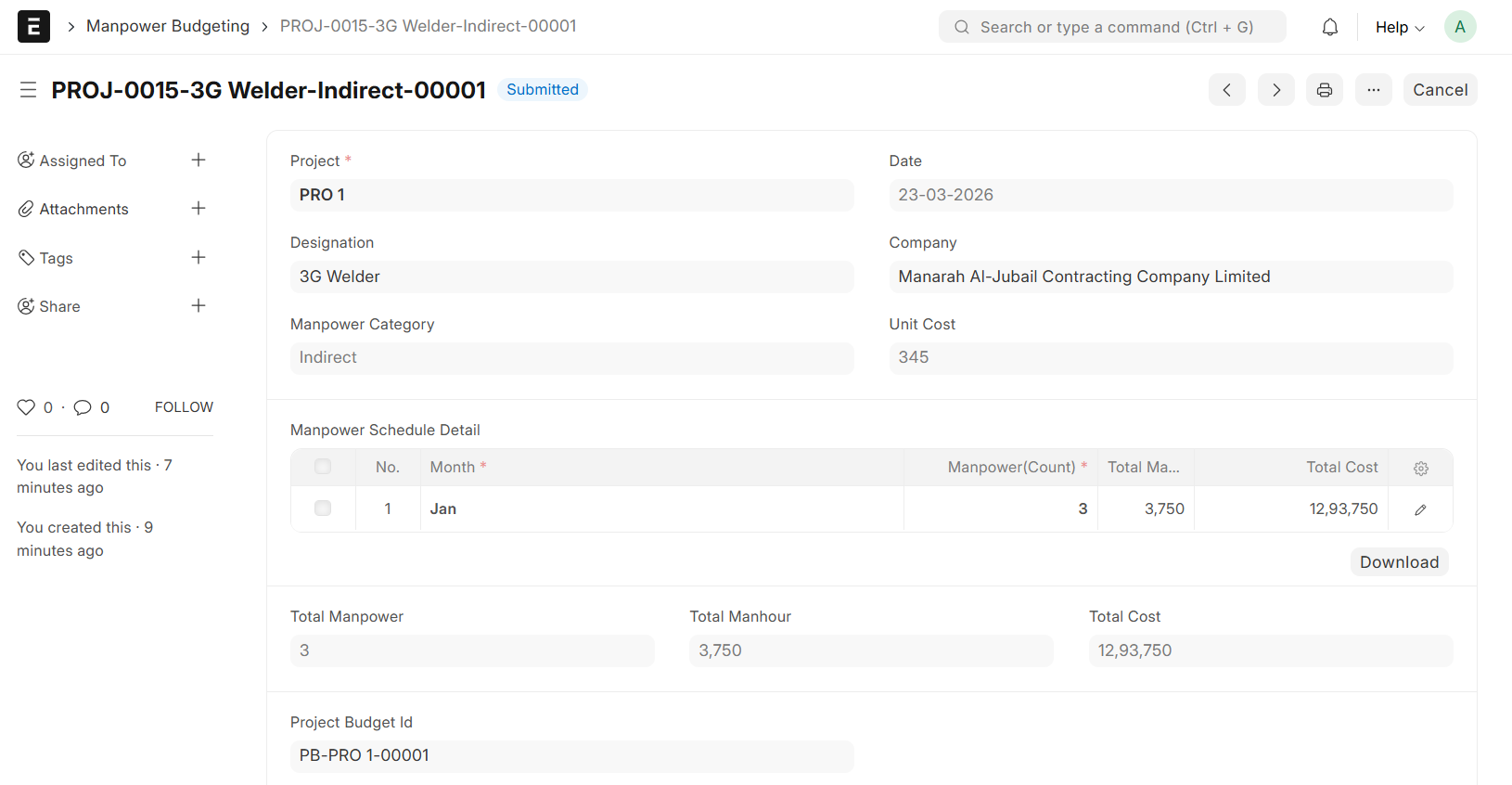

  • Go to Manpower Budgeting, Add Manpower Count, Unit Manhour, Working Days, Month and Save & Submit
  • The Details will be auto fetched to Indirect Manpower Cost Table

{E748C971 CFBF 4BD8 8644 0018EFF2CF71}

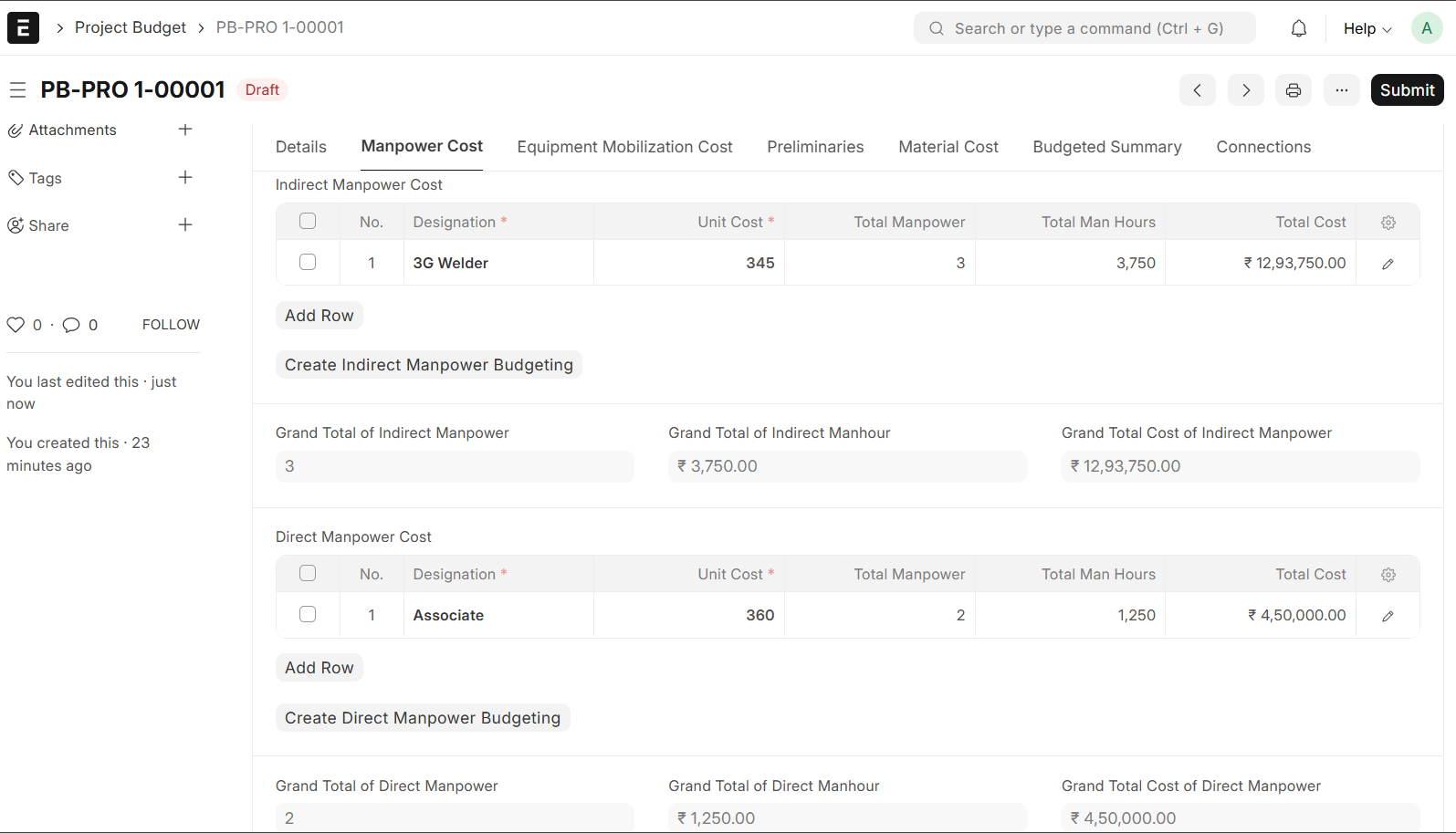

  • The same process applies to the Direct Manpower Cost section; follow the steps above to generate and Submit the corresponding Budgeting Detail

{CC588558 2F44 4C44 8732 199E8D685485}

Equipment Mobilization Cost

This section tracks the cost of bringing Machinery and Vehicles to the project. It calculates a hourly 'Unit Price' based on monthly Rental fees and Additional costs like Food and Housing for the operators

  • Select Equipment or Vechicle Type
  • Enter Monthly Price and Food & Accomadation
  • The Unit Price will be auto calculated (Formula: Total Price / Standard Working Hours (Per Month)) and Save
  • Click on "Create Equipment Budget"
  • Equipment Budget Document will be generated

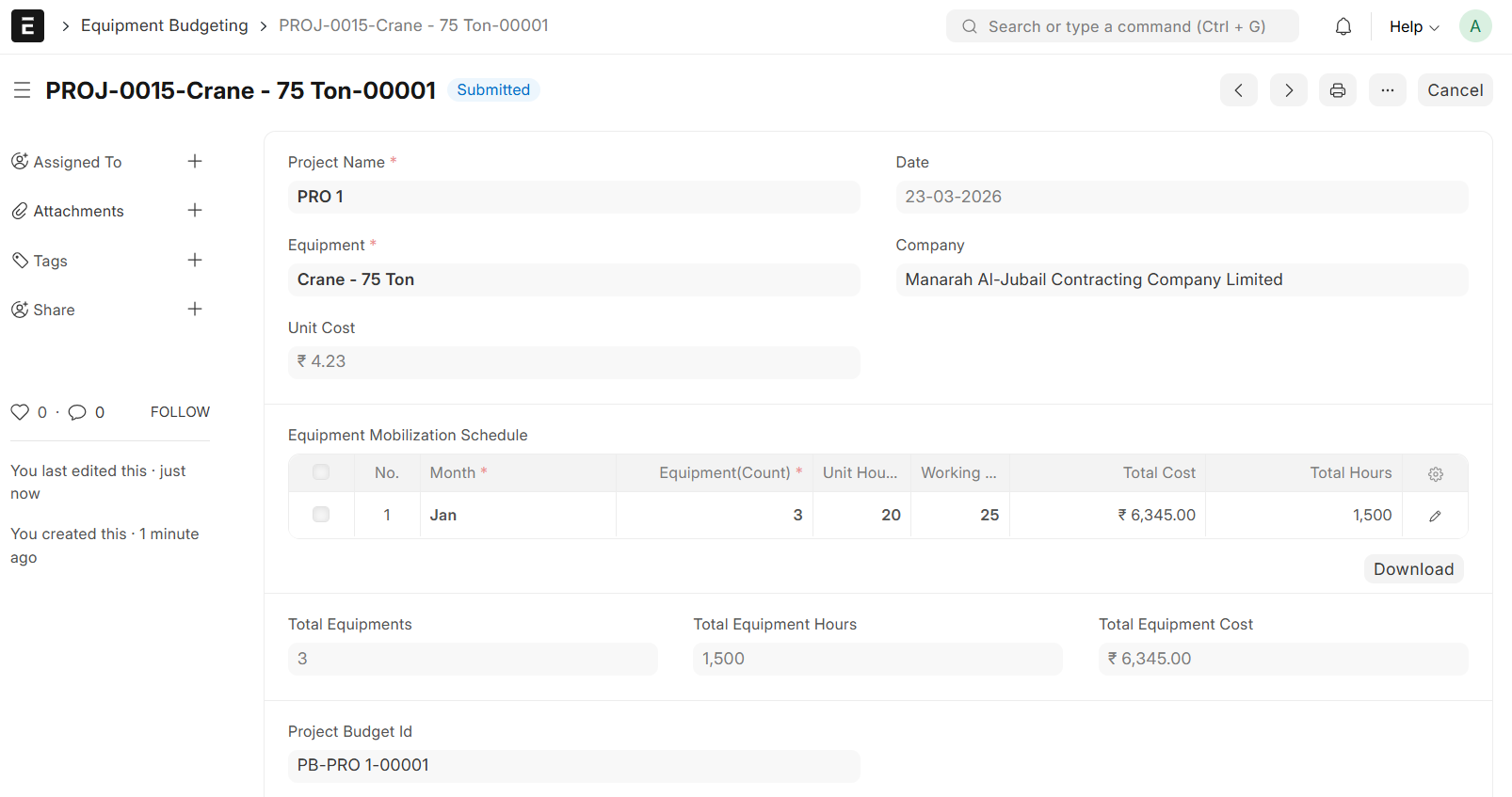

  • Go to Equipment Budgeting and Add Month, Equipment(Count), Unit Hour, Working Days and Save & Submit
  • The Details will be auto fethced to the Equipment Cost Table

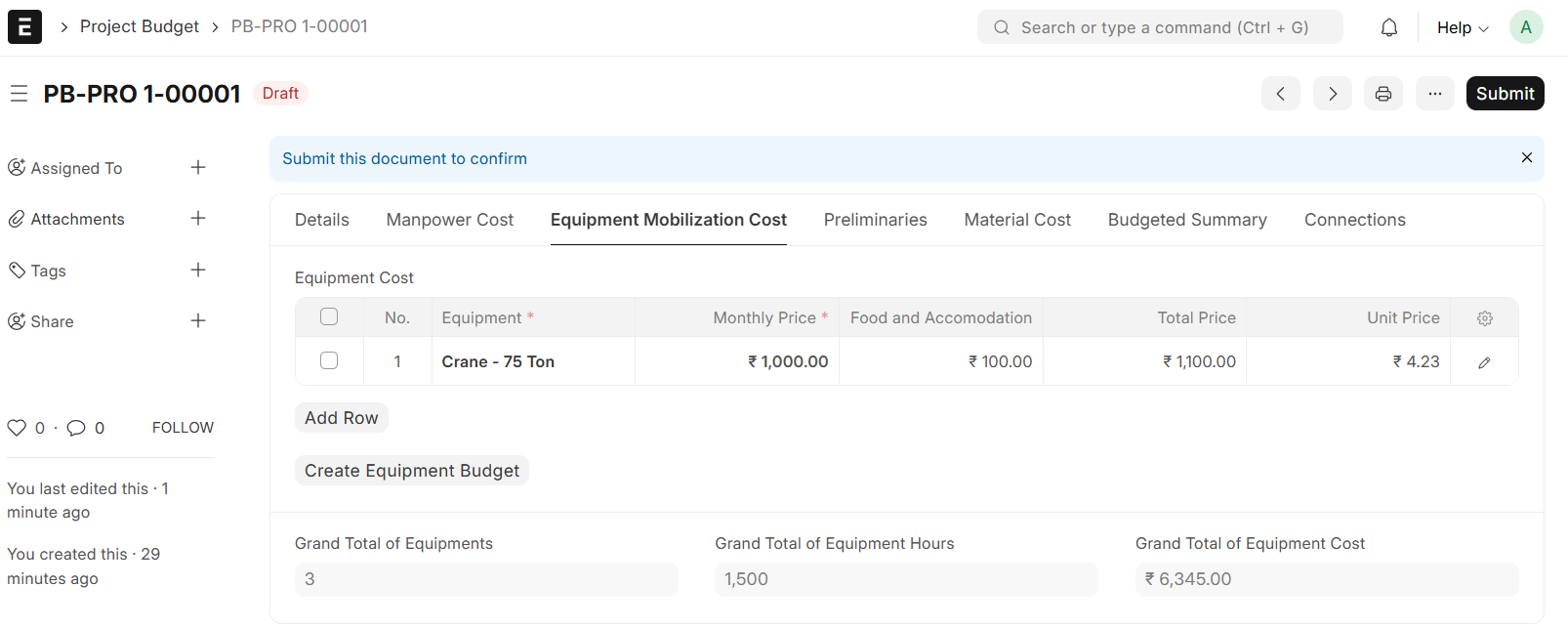

{B3871767 4D7F 413B A900 2AE037DA937D}

{7C9F781B 38CB 4248 8EB1 4091EE446F3B}

Preliminaries

Preliminaries are the General Expenses required to run the Project that aren't tied to a specific building task

  • Select Preliminary Cost Categories
  • The Details will be auto fetched to the Table
  • Add required Quantity and Save
  • The Grant Total cost will be auto calculated

{356276E8 824A 485A A5D8 086C453191DE}

Material Cost

The Material Cost section is used to List all the physical items and supplies needed for the project. It calculates the Total Cost based on the Quantity required and adds a small extra percentage for 'Consumables'

  • Select Item
  • Unit and Unit Cost will be auto fetched

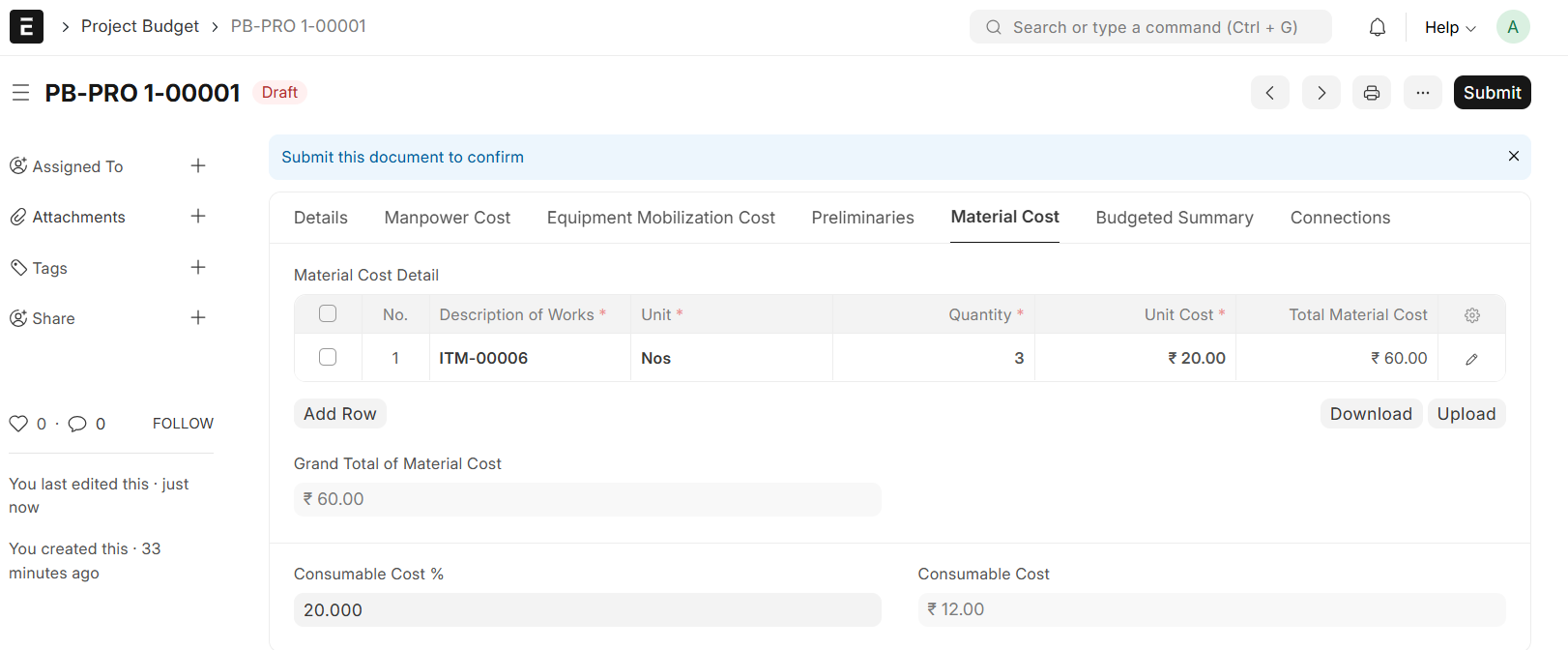

  • Enter Required Quantity
  • Enter Consumable Cost % and Save
  • The Grant Total Material Cost and Consumable Cost will be auto calculated
  • Then, Submit

{651E5F9D CD68 43C3 B000 9829F5F6FFA8}

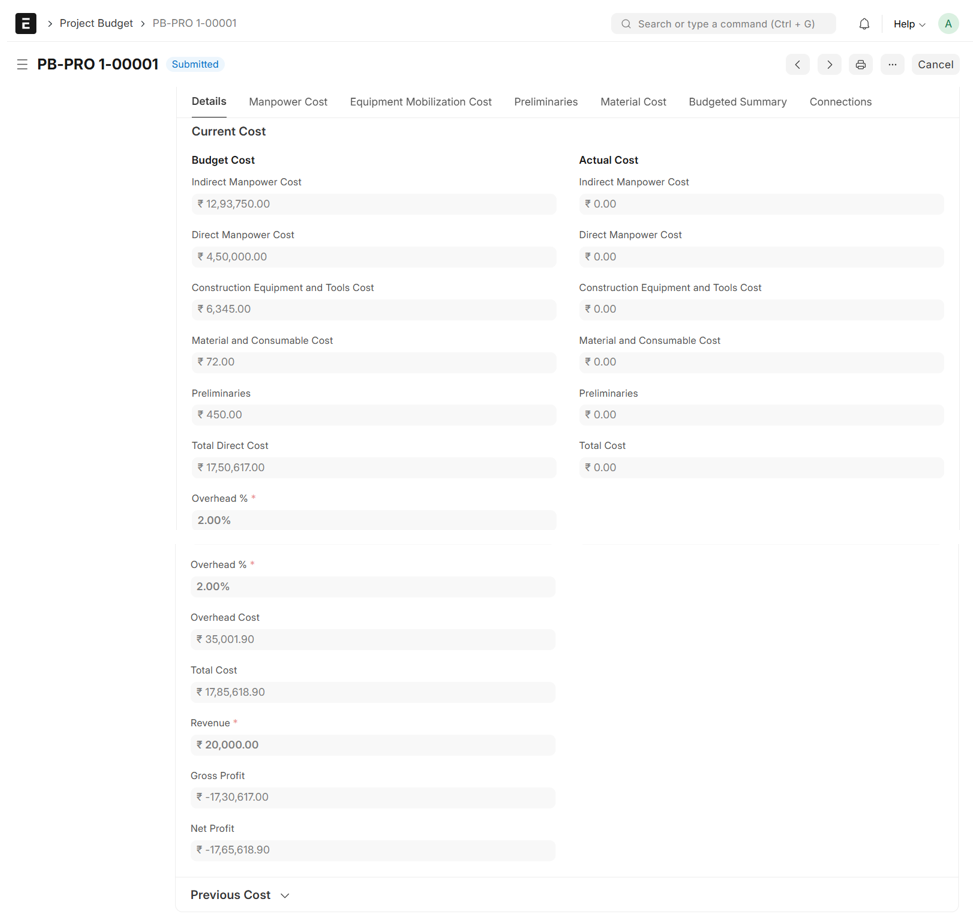

  • The Whole Budgeted Costs will be displayed under Budget Cost
  • The Budget Gross Profit and Net Profit will be calculated automatically
  • The Actual Cost section is automatically updated upon the submission of the Project Timesheets and Other related Documents

{46E8BF40 0887 427F A844 4D286D22B892}

Note:

To Revise an existing Budget, generate a new Project Budget entry with the revised values. Upon saving, the system will automatically deactivate the previous version and migrate its data to the Previous Cost section of the new budget for historical comparison
